Workforce Capacity Planning: How to Know What Your Team Can Actually Absorb

How to plan workforce capacity without guessing: the formula, the six steps, and why contractual hours minus a round overhead number is not real capacity.

Vanja Savic Petrovic
May 6, 2026
5 min read
Full access. No credit card required.
4.8
Top Rated Platform
Summarize With AI

On this page

Measure the work, not the signal.

See productive time and utilization by team, not just what looks active.

4.8
Top Rated Platform

Key takeaways

  • Workforce capacity planning shows whether your existing team can absorb expected demand during a defined period before you commit to the work.
  • The standard formula for workforce capacity is: Workforce capacity = Employees × Working hours × Workdays − Absences − Non-project overhead.
  • Capacity estimates fail when contractual hours and assumed overhead are treated as reliable indicators of the time people can apply to planned work.
  • The six stages of workforce capacity planning are: defining demand, measuring capacity, accounting for overlooked work, comparing demand with capacity, choosing a response, and reviewing the outcome.
  • A capacity shortfall usually means the current plan needs to change through resequencing, reduced scope, or redistribution before you assume more people are required.

Workforce capacity planning determines how much work your team can realistically handle during a defined period. A reliable plan compares expected demand with measured capacity, meaning the time the team can apply to the work.

That calculation should rest on evidence about how work happens rather than a headcount. The familiar workforce capacity formula, which multiplies employees by working hours before subtracting leave and overhead, isn’t wrong. Its inputs are.

Contractual hours tell you when someone is expected to be present, not how much of that time they can apply to the work. A blanket overhead percentage hides time lost to meetings, fragmented schedules, rework, and waiting on inputs.

Six steps below build a capacity baseline from evidence rather than contractual hours, test it against upcoming demand, and set out what to do when the work does not fit.

What is workforce capacity planning?

Workforce capacity planning is the process of determining how much work your employees can absorb in a given period before you commit to it. Capacity planning in workforce management compares workforce capacity with expected demand to establish whether you have enough staff to meet your operational objectives.

A capacity plan gives you a team-level view across a defined window, such as a quarter, a seasonal peak, or a product launch. It establishes what the team can reasonably deliver before deadlines and budgets get set around expectations that may not hold.

Employee capacity planning requires more than stacking tasks against a count of people or scheduled hours. It should reflect the time the team has left for the work after accounting for activities that consume capacity without appearing in the plan, including delays, rework and meetings. With that baseline, you can determine whether the demand fits, requires changes, or exceeds what the team can absorb.

Capacity planning is often confused with resource planning, which assigns the people and other resources needed to complete specific work. This guide explains capacity planning vs. resource planning in more detail.

It also differs from team workload management, which focuses on how work is distributed among individuals from week to week, and from headcount planning, which begins when a persistent capacity shortfall raises the question of whether you need more people.

The capacity formula, and where it breaks

The standard workforce capacity formula calculates the hours your team should have available after subtracting the time that can’t be applied to planned work. It looks like this:

Workforce capacity = (headcount × available hours in the period) − leave − non-project overhead

The calculation itself is straightforward. Its inputs are the weak part. They describe an ideal version of the working period rather than how work happens, and when those assumptions go untested the formula produces a precise-looking number that misrepresents what your team can absorb.

Each input fails in a different way.

  • Available hours: These are contractual, not operational. They tell you when someone is expected to be present, and presence doesn’t mean every hour goes to planned work. Parts of the day get consumed by essential responsibilities outside the plan. Other parts are too fragmented to support the work you are estimating.
  • The overhead deduction: Many teams subtract a round percentage for meetings and administration. That percentage may have been set years ago or copied from another team, and it doesn’t move when processes or working patterns change. Because overhead can consume a meaningful share of the period, a weak assumption here creates the largest error in the plan.
  • Leave: Leave tends to be the most reliable input. Approved time off is usually recorded and easy to deduct. It’s also narrower than the activity hidden inside an overhead estimate.

These flaws produce a systematically optimistic plan, one that encourages commitments with no room for normal variation. Teams fall behind, pressure builds, and targets get missed.

Imagine planning a product launch using scheduled hours, known leave, and a standard overhead deduction. During delivery, meetings take longer than assumed, approvals slow the work, and rework consumes time nobody included. No single disruption breaks the plan. The problem is that the original capacity never existed.

Poor inputs distort the picture in the other direction too. An overhead allowance based on an unusually meeting-heavy period can make your team look fully committed long after those demands have eased. Leave that assumption unrevised and the available capacity stays hidden.

Whether the cost lands on people or on budget, you can’t make a reliable capacity decision until your inputs reflect how the work gets done.

The workforce capacity planning process, step by step

The six stages of workforce planning are defining demand, measuring current capacity, accounting for overlooked work, comparing capacity with demand, choosing a response, and reviewing the outcome.

This capacity planning process turns a rough estimate into a plan you can test and correct.

1. Define the period and the demand

Start by establishing a clear planning window and demand forecast. Decide what work is coming, when it must be completed, and which roles it requires. A capacity plan without a defined period is just a general estimate.

Separate committed work from work that’s still uncertain, or a possible project will distort the capacity you reserve for confirmed priorities. If demand may change, plan around the most likely scenario and document the conditions that would require another review. The goal is a shared understanding of what the team may need to absorb during that period.

2. Measure current capacity

Build a baseline of the time the team has available for the planned work. Use recent activity and time data instead of treating contractual hours as fully available.

The baseline should reflect how work happens under conditions similar to those you’re planning for, so choose a representative period. A quiet month overstates capacity. An unusually demanding one understates it.

Break the baseline down by role when skills aren’t interchangeable. For distributed teams, apply the same measurement approach across locations, so differences in schedules or working patterns don’t turn into inconsistent assumptions.

3. Account for the work nobody counts

This step produces an evidence-based overhead assumption. It begins with identifying the demands your forecast leaves out.

Start by measuring the time absorbed by meetings, context switching, and administrative responsibilities. Then look at delays caused by waiting for inputs, and work that has to be redone.

Some of this work is necessary, so the aim isn’t to eliminate it. You’re trying to represent it accurately. Note which demands are stable and which are temporary, since they shouldn’t shape plans in the same way.

Use that evidence to replace the inherited overhead percentage, and update the assumption whenever working conditions change.

4. Compare demand against capacity

This step produces the answer the whole exercise exists for: the work fits, it fits with changes, or it does not fit. Set the work you expect the team to complete against the usable capacity available in the same period.

Start with the total gap, then find where it sits. The totals may look balanced until you break them down and find the team has capacity overall while a critical role is already stretched. That bottleneck may decide whether the full plan is realistic.

If the gap is narrow, consider what happens if demand rises or usable time falls. A slight change in either can create a bottleneck or leave capacity unused. The work fits only when the necessary capacity exists in the right roles at the right time.

Record the conditions that must remain true for the plan to hold. That turns the comparison into an evidence-driven decision instead of a single number.

5. Decide what changes

Once you can see a capacity gap, turn it into a plan for making the work fit. Consider the four responses in this order:

  • Resequence the work
  • Reduce its scope
  • Redistribute it where suitable capacity exists
  • Add people if the shortfall remains

Start with the changes that improve fit without increasing fixed costs: resequence, reduce, or redistribute. Document the effect each option would have on timing, scope, and risk before choosing. Adding people comes last because it’s the slowest response and may not close an immediate gap.

The five Rs offer a useful check. Do you have the right people with the right skills? Are they in the right roles, at the right time, and at the right cost? Use those questions to improve capacity and headcount planning and avoid treating every shortfall as a hiring problem.

6. Review against what happened

This step uses actual delivery to correct the inputs in your next plan. At the end of the period, compare the capacity you expected with what the team completed. Identify where demand changed and where your assumptions about usable time were wrong.

Review the plan at the end of every planning period. Revisit it sooner when demand, staffing, or delivery conditions change materially.

During reviews, focus on the gaps between the plan and the outcome rather than on whether the original estimate was technically followed.

Then update the capacity baseline and overhead assumptions with what you learned. That feedback loop is what makes each new plan more reliable than the last.

What a capacity plan should contain

The five key elements of a workforce plan are its planning period, demand forecast, available workforce, capacity gap, and action plan. A workforce capacity planning template helps you apply these elements consistently.

Every element below needs evidence behind it rather than an assumption:

Element What good evidence looks like
Planning period A defined start and end point tied to the planned work.
Demand forecast Work that's confirmed and likely to happen, with expected outputs and timing.
Headcount by role The people available during the period, grouped by the roles or skills the work requires.
Measured available capacity The time each role can realistically apply to the planned work, based on recent activity, time data, and work location patterns.
Overhead assumption The share of available time consumed by necessary non-project work, supported by recent activity and time data.
Capacity gap The difference between forecast demand and measured capacity, including any shortages by role.
Chosen response The change you'll make if the work doesn't fit, along with its effect on scope, timing, or resources.
Replanning trigger A specific change in demand, staffing, capacity, or delivery that would require you to review the plan again.

What unread capacity signals cost

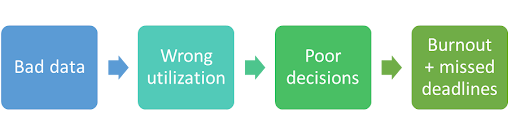

Unread capacity signals create unnecessary labor costs by hiding the difference between the capacity you’re paying for and the capacity being used. When that gap isn’t visible, you may approve more spending or add more people even though the existing workforce could absorb the work.

Usually the fault sits in the data behind the estimate. A schedule shows when people are expected to work. An invoice shows what a company was billed. Neither confirms how much time someone applied to the work, and treating either as measured capacity leaves usable time unrecognized.

An Insightful customer and leading US bank discovered this when it began measuring the workforce capacity of its 3,000 external IT contractors based on the work they actually did. Previously it had estimated capacity from contractor billing data, so leadership had no clear view of daily work activity or whether the spend was producing a return.

When the bank began measuring work activity, the data showed it was being billed for 25% more hours than were actually worked. Consultants were also spending more than 36% of their time on messaging apps rather than their IT tasks.

Once the bank could see the gap, it found its available capacity was 27% larger than the invoices suggested. It shrank its external workforce by 27% while keeping the same level of output. That produced $2.5 million in contractor savings within three months, on track to reach $10 million annually.

The issue was never how much capacity the bank had. It was that the estimates came from data that did not represent how the work happened.

How to measure real capacity

You measure real capacity by looking at how much time the team has for planned work under normal working conditions. For employee capacity planning, that means building a baseline from activity and time data instead of assuming every scheduled hour is available.

A reliable baseline should show:

  • How time is distributed across work types: Separate time spent on core responsibilities from meetings and administrative work. That shows how much of the working day is available for the demand you’re planning.
  • How much working time is continuous: A team may appear to have enough hours overall while the time is too fragmented for focused work. Look for periods broken up by meetings or frequent shifts between tasks.
  • Where work is waiting: Time lost while people wait for decisions, information, or approvals reduces capacity. Identifying those delays also shows where a process change would release more of it.
  • Where work is being repeated: Rework consumes time without increasing output. Look for recurring corrections and duplicated effort, and include them in the baseline rather than treating them as exceptions.

For this to be practical, your system needs to organize activity and time data by team, role, and period. It should show patterns without requiring you to reconstruct each person’s day by hand, and let you compare working patterns across locations where schedules and operating conditions differ.

Workforce Analytics gives you visibility into the activity and time patterns that shape real capacity, including how much available time is being used. You can use that measured data to calculate utilization, compare capacity with forecast demand, and refine your baseline as conditions change.

When the plan says the work doesn't fit

When a capacity plan shows the work doesn’t fit, you can resequence it, reduce its scope, redistribute it, or add people. The goal is the smallest change that makes the plan realistic without raising costs or creating a problem elsewhere.

Try these responses, in this order:

  • Resequence the work: Move lower-priority work to a later period so the team can focus on what matters now. This protects scope but may shift deadlines or affect dependent work.
  • Reduce the scope: Remove or simplify lower-value requirements. This preserves the delivery date and means accepting a smaller outcome.
  • Redistribute the work: Move suitable work to a team or role with available capacity. This only works where the required skills transfer, and moving too much creates a new bottleneck.
  • Add people: Increase capacity when the other responses can’t close the gap. This raises costs and takes time, so it rarely belongs first.

A seasonal or temporary gap may need only a short-term adjustment. If the shortfall continues across planning periods, it becomes a headcount planning question about whether the organization needs more people.

Plan against what the work actually takes

Workforce capacity planning fails when contractual hours and guessed overhead are treated as reliable inputs. That creates a plan built on time the team doesn’t have.

Use inputs based on how the work happens and you get a capacity plan that reflects what the team can absorb.

Insightful’s Workforce Analytics gives you the activity and time data to measure real capacity, compare it with expected demand, and build plans on evidence instead of assumptions.

Start a free trial to see what your team can realistically absorb before you commit to more work or more spending.

Frequently asked questions

What is capacity planning in workforce management?

Capacity planning in workforce management determines whether employees can meet expected demand within a specific period. It brings workforce supply and planned work into the same view, helping leaders make realistic commitments, identify likely shortfalls, and decide what needs to change.

How do you calculate workforce capacity?

To calculate workforce capacity, multiply the number of employees by their working hours and workdays, then subtract absences and non-project overhead. The weakest input is overhead, because many teams apply a standard percentage instead of measuring how the time is really consumed.

What are the stages of workforce capacity planning?

The six stages are: define the planning period and forecast demand; measure the team’s current capacity; account for overlooked work; compare demand with capacity; choose how to close any gap; and review planned capacity against actual delivery.

What is the difference between capacity planning and workload management?

Capacity planning assesses how much work a team can absorb across a defined period. Workload management distributes work among individuals from week to week. Capacity planning tells you whether the work fits in aggregate; workload management helps you assign it fairly and respond when someone has too much or too little.

How often should a capacity plan be reviewed?

Review a capacity plan at the end of every planning period, so you can compare expected capacity with actual delivery. Review it sooner if the expected workload changes, team availability shifts, or delivery starts falling behind the plan.

What do you do when the work does not fit?

Try resequencing the work, reducing the scope, or redistributing suitable work first. If those changes don’t close the gap, you may need to add people. Working through them in that order tests the lower-cost adjustments before increasing headcount.
